UDC 622.271.3:012.3.001:622.281.424





Yerkin Iskakov, Ph. D., Master of Mining Kazakh National Technical University named after K.I. Satpayev.





Construction of stations of columned type of the subway in Almaty.



Construction of stations by underground way belongs to the most difficult types of works in subway construction as it is connected with the device of a complex of the interconnected constructions and disclosure of developments of big section. Construction conduct in such technological sequence not to allow a deposit of the terrestrial surface, buildings dangerous to safety and constructions, and also a deposit of underground communications of the municipal economy located above station. Motions of the soil massif and a flash of a roof of developments have to be minimum.

At construction of stations by underground way use usually working mine trunks, but also inclined (esñalator) tunnels, and in some cases ventilating trunks and distillation tunnels can be used.

The main (platform) part of station constructs the line method providing a continuity of maintaining all complex of works in strict technological sequence. Thus use the principle of the maximum combination of separate types of works in time. Such organization of works provides the smallest duration of construction.

Three-vaulted stations construct by a consecutive driving of three station tunnels.  At first construct lateral tunnels, and then — average.

In not rocky soil putting pressure from a forehead of a face, a construction conduct with a preliminary driving the pilot tunnels, by means of boards or  banquette way.

For a possibility of management of the provision of designs an cast in-situ lining on station distance a driving of tunnels of three-vaulted stations with monolithic ferroconcrete cast cast in-situ lining conduct in one direction. At a construction of stations in unstable soil a driving of the second (on sequence of a construction) a lateral tunnel not less than 30 m concerning the first, and an average — with lag conduct with lag not less than 50 m concerning the second lateral tunnel.

The way of development and face fastening at construction of stations establish depending on properties of developed soil. At a driving of station tunnels in the  banquette way soil develops tunnel excavators with a ladle of active action.

Development of a face at a driving of separate station tunnels of three-vaulted stations conduct, as a rule, on width of 1 m.

Construction of an cast in-situ lining of lateral tunnels of three-vaulted stations conduct usually closed rings, and with the party turned to average part of station, along with usual elements establish the elements entering subsequently into structure of the main bearing design (a column, randbalka and basic beams).

In places of future passes in an cast in-situ lining  carry out temporary fastening.

At the device of a monolithic ferroconcrete cast in-situ lining   of lateral tunnels only vertical ellipticity (increase in vertical diameter) is allowed.

Average station tunnel pass with acceptance of necessary measures for prevention of deformations of an cast in-situ lining   of lateral tunnels and shifts of columns.

For this purpose in lateral tunnels establish steel racks from metal pipes, and on the average a tunnel executions from metal pipes.

Monolithic concrete or ferroconcrete elements of an cast in-situ lining    of station erect separate sites with application, as a rule, the mobile mechanized  or inventory collapsible timbering’s and other specialized equipment (pneumoconcrete placers, concrete pumps, mechanical  of a timbering).

Length of sites of concreting depends on the accepted way of a construction of station and construction of elements of an cast in-situ lining.

Sequence of a construction of station of columned type on the NATM technology with a ferroconcrete monolithic cast in-situ lining   the following:

                • pass lateral station tunnels in the way of the bottom ledge with lag of a face of the second tunnel not less than 30 m concerning the first;

Driving of the second (on sequence of a construction) a lateral tunnel conduct with a reinforcement of the arch of the first tunnel vertical racks from metal pipes with a diameter of 300 mm, establishing through 1,5 m on two racks with a crossbar.

Racks establish on 15 m ahead concerning a face of the second tunnel. Racks of temporary fastening in the second lateral tunnel establish before a construction of an average tunnel.

               carry out in sequence from the cross camera a waterproofing of lateral station tunnels the PVC film;

             • carry out step by step a monolithic ferroconcrete cast in-situ lining     of lateral station tunnels;

            • carry out in lateral station tunnels step by step monolithic ferroconcrete columned and crossbar ranks;

Each part concrete in 2 stages. At 1 stage concrete a ferroconcrete tray at length of a part of a mobile timbering.

Concreting of a site of a wall and the arch conduct continuously by means of the pneumonic supercharger. Breaks when concreting (on horizontal seams) shouldn't exceed 2 h.

The device of working seams is allowed only on a horizontal axis of a tunnel. At the same time conduct concreting of a site of a columned and crossbar row continuously by means of the pneumonic supercharger. Breaks when concreting (on horizontal seams) also shouldn't exceed 2 h.

After a set concrete of design durability makes concreting of the following part.

            • calotte an average station tunnel from the cross camera pass the first 9 m in the mountain way, and the subsequent part pass the NATM method on 7 m in temporary shot concrete fix;

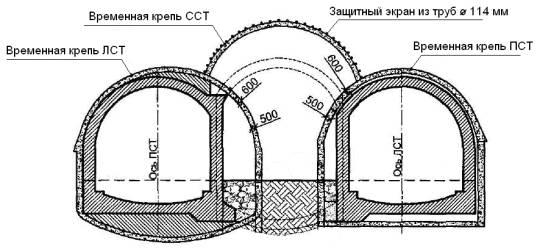

Figure 2 - Technology of a driving of station of the subway of NATM



            • carry out in sequence from the cross camera a waterproofing of the top arch part of an average station tunnel the PVC film.

            • carry out step by step part on 10 m a monolithic ferroconcrete cast in-situ lining   of the top arch of an average tunnel with the device of knot of an bear on on columned and crossbar ranks of lateral tunnels;

            • pass in temporary shot concrete  fix strosse an average station tunnel on the first part – 9 m, on the subsequent – 7 m with installation of executions of temporary fastening from the metal pipes Æ300 mm;

            • carry out a waterproofing of a part of the lower arch part of an average station tunnel a method of drawing waterproofing composition;

            • carry out step by step part on 8 m a monolithic ferroconcrete cast in-situ lining    of the return arch of an average tunnel with the device of knot of interface of the arch with a basic beam of a columned and crossbar row;

          • carry out dismantle of executions temporary fix.

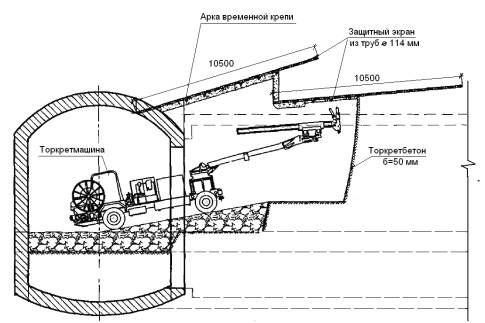

Figure 2 - Baikonur station construction with advancing supports and the NATM elements.



The device of the next part of a monolithic ferroconcrete cast in-situ lining   of an average tunnel carry out after a set 75% of durability of concrete of the previous part. Surface shot concrete, reinforcing frameworks of a part carefully level, carry out concreting.

Temporary filling of apertures investigate in the course of a driving and development calotte an average tunnel. It gives the chance to give out developed soil and to give materials through lateral tunnels.

In the course of construction continuous control of deformations is conducted fix.
