V. Levykin, Doctor of Technical Sciences, Professor

I. Iuriev, Ph.D. student

Kharkiv National University of Radioelectronics, Ukraine

Stages and results of typical project on development of IT organization strategy

IT strategy is a strategic plan of management of the information technology development of the company, which is aimed at meeting requirements of business and achieving desired goals on development of the information technology used in the company.  Basically, IT strategy is a part of the general strategy of company development, where it is stated how, in what period, at the expense of which technologies and means a company can improve its business efficiency. It answers the question how a company should conduct business in the context of information technology in order to achieve desired goals.

The lack of IT strategy in the company leads to a quite low benefit from implementation of IT projects due to the non-compliance with business requirements[1]. It gives rise to complaints against work of IT service from the management, consideration of IT service not as a full business participant but as a subdivision, providing services to the business, in other words executing only helping function. In this case, investments made into IT are seen as a waste and IT service carries out projects which are not associated with strategic goals of the company [2]. In its turn, IT strategy allows to develop IT infrastructure of the company on the basis of distinctly developed requirements and the strategy turns up to be a starting point for tactical decisions, which correspond to business goals of the company.

The development of IT strategy of the company is described in the form of the sequence of stages, stating tasks and appropriate results [3]:

1)                    Stage 1. Project preparation.

2)                    Stage 2. Analysis of the main strategic goals and the company.

3)                    Stage 3. IT strategy development.

At the first stage it is necessary to carry out the following tasks:

̶                     Form task description and organize project team;

̶                     Agree upon the structure of data collected and adapt templates;

̶                     Define project frames, its structure and all the necessary reporting documents;

̶                     Develop and agree upon the project charter;

̶                     Prepare and approve detailed work plan.

As a result of the execution of this stage the company will get: project charter and calendar work plan; approved scheduled plan of the necessary interviews, approved scheduled plan of the necessary business trips, templates and forms for collecting primary information, structure of reporting documents agreed upon.

At the second stage it is necessary to carry out:

-  Analysis of the structure and technological condition of used information systems and principles of their integration;

-  Analysis of the integration level of information systems;

-  Analysis of the structure and technological development level of IT infrastructure of the company;

-   Analysis of the structure and the development level of IT management system;

-  Formation of the integral estimate of the current condition of the information technology;

-  Formation of general conclusions and main directions of development.

As a result the company will get the following documentation: expert conclusion on the development level of information system, IT infrastructure, integral estimate of the current condition of the information technology, report with general conclusions and main directions of IT development.

At the third stage it is necessary to carry out the following tasks:

-  Development of the goals of information technology development;

-  Development of business principles of information technology development;

-   Development of perspective structure of the corporate information system of the customer;

-  Development and explanation of the choice of strategy of information technology development;

-  Development of the list of necessary IT solutions;

-  Estimate of the budget of the strategic plan;

-  Estimate of efficiency of IT projects implementation;

-  Development of approaches to management and implementation of IT strategy.

After completing this stage the following will be determined: goals, tasks, IT development principles, prospective structure of corporate information systems, target architecture of all IT elements, budget of planned events, options for managing, monitoring and controlling implementation of IT strategy.

In general, the relationship of the company's IT strategy, with information systems, is presented in Figure 1.

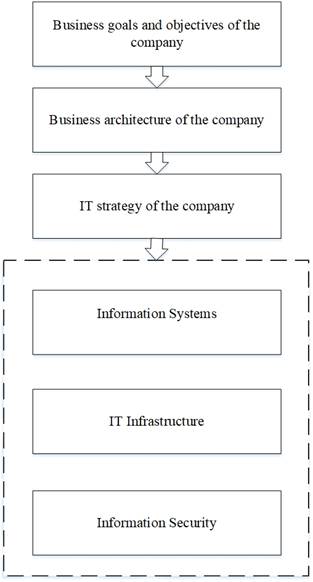

Figure.1. Connection of IT strategy with information systems

Conclusion. The lack of IT strategy usually results in the fact that IT department is mainly engaged in the execution of projects that are not directly related to the strategic goals of the company. At the same time, the benefit from investments made into such projects, as they are executed without considering the requirements of business development, may turn out to be more than questionable.

The availability of IT strategy represented in the form of a formalized document allows us to develop IT infrastructure efficiently on the basis of a correct presentation of the requirements that should be implemented for the successful business development of the company, as well as to carry out pre-planned steps, moving towards achievement of desired goals. The strategy should be a tool for making tactical decisions that correspond to business goals of the company.

It is worth mentioning that IT strategy can also be modified in conditions of an ever-changing market, this being said such process also requires appropriate formalization.
